Restoration – Winding Engine House Roof Restoration

This page provides an overview of the process of the restoration of the winding engine house roof, from before the work began, through to completion.

The Friends of Hemingfield Colliery and volunteers would like to acknowledge the support of the following in achieving this work:

This slideshow requires JavaScript.

Starting point

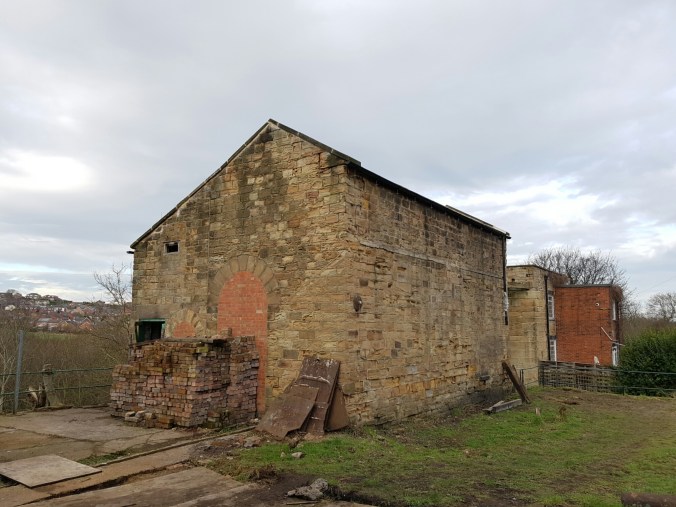

Before work began in October 2016, the roof of the winding engine house was in a poor state of repair, with numerous holes in the slates, significant decay and the beginnings of collapse in the timberwork, an much of the guttering and pipework broken or robbed away.

p1050018-reduced

Before work commenced: 15th October 2016

The damage was especially bad where the 1846 sandstone building joined the later brickwork extension, where the rafters were exposed and silt and weeds blocked the drainage. Trees had even begun to take root in some parts of the roof and walls.

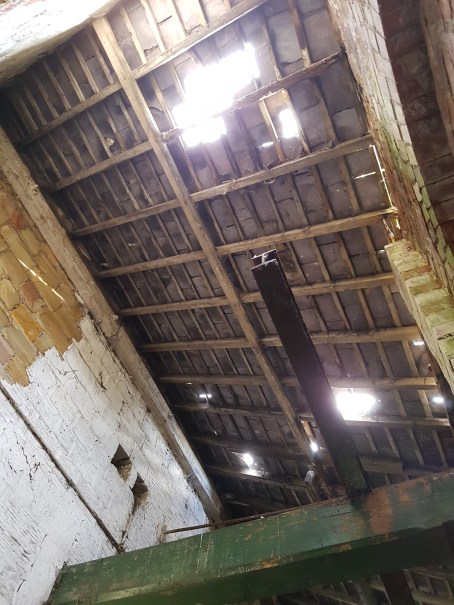

Inside view of the roof decay (17th September 2017)

Inside view of the roof decay (17th September 2016)

Pre-restoration roof damage (17th September 2016)

Pre-restoration roof damage (17th September 2016)

Work begins

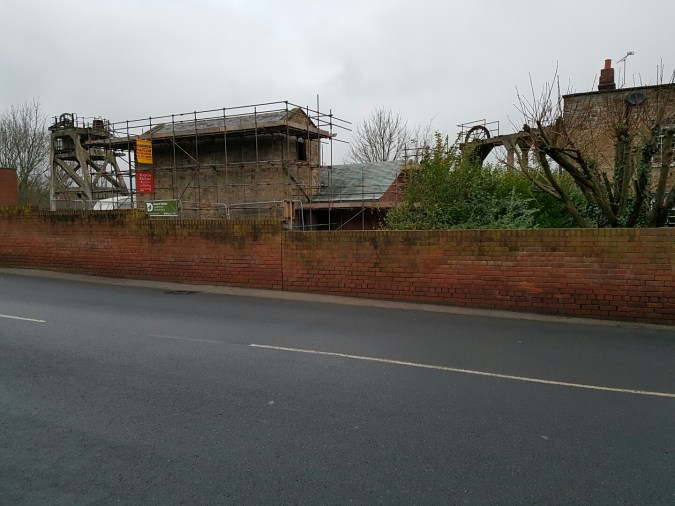

Work began with the arrival of scaffolders, on the 18th October 2016. The initial preparation of the site included laying down plywood boarding to enable the movement of scaffold poles and boards.

img_20161023_155943597

Scaffolding going up, 23/10/16 (Photo credit: Andrew Jones)

img_20161023_160819397_hdr

Sunday 23rd October 2016 – scaffolding emerging trackside

sdc10015

Winding engine house roof seen from the Dearne and Dove Canal, 23/10/16 (Photo credit: Andrew Jones)

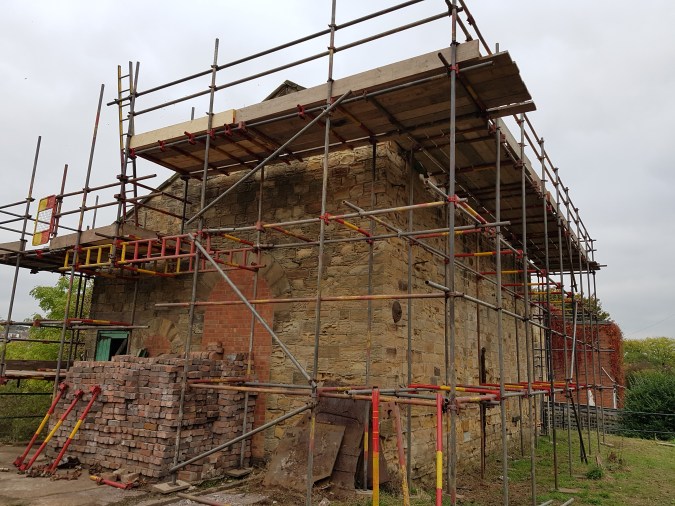

20161029_142750

29th October 2016


29th October 2016


29th October 2016

20161029_114656

29th October 2016

Roof work up-close

The scaffolding presented a unique opportunity to see details of the building visitors never normally get to see.

Detail of the damage to be fixed, 12th November 2016

Detail of the damage to be fixed, 12th November 2016

20161029_131556

10th December 2016

20161029_131340

10th December 2016

Roof, rooves and reroofing

The challenge was to get up close and personal with the existing rooves; rooves plural because the building now standing is the result of a mixture of phases of activity in the colliery’s working life:

  •  the tall but narrow original sandstone winding engine house which housed the first vertical cylinder beam winding engine for the main working shaft (bye pit);
  • the late 1930s partial rebuild of the former winding drum house, which continues the roof pitch of the above. Originally partly timbered, it was later consolidated in brick with stone facings when the winding engine was altered.
  • on the lower part of the site, by the old pumping shaft (engine pit), a much altered late nineteenth century brick workshop, latterly housing the electric winder for the old pumping shaft.

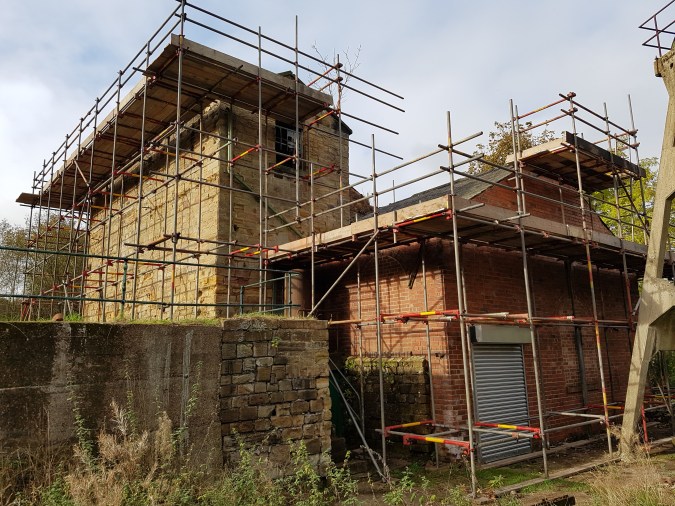

20161029_132001

All three main elements of the winding engine house. Left the oldest tall and narrow building; next to it, continuing the roofline the brick extension; in front, the ridgeline of the nineteenth century shops (29th October 2016)

 Stripping down

Once safely and securely erected, the scaffolding was used to removed for re-use the roof slates. Their removal revealed the rotten battens beneath, which all needed to be removed to strip the roof down for restoration to begin.

Rotten battens removed after slates taken off roof for reuse (26th November 2016)

Temporary cover

As the old and worn roof materials were removed, a temporary tarpaulin way fastened down to keep the building dry and lay a foundation for the waterproof membrane and new battens which would eventually take its place.

11th November 2016 (Photo credit: Ian Hateley)

11th November 2016 (Photo credit: Ian Hateley)

The new cover

10th December 2016

Some of the slates retained for reuse (10th December 2016)

10th December 2016

Membrane, battens and grey-painted fascia in place on the winding enginehouse roof. (10th December 2016)

New Slates for Old

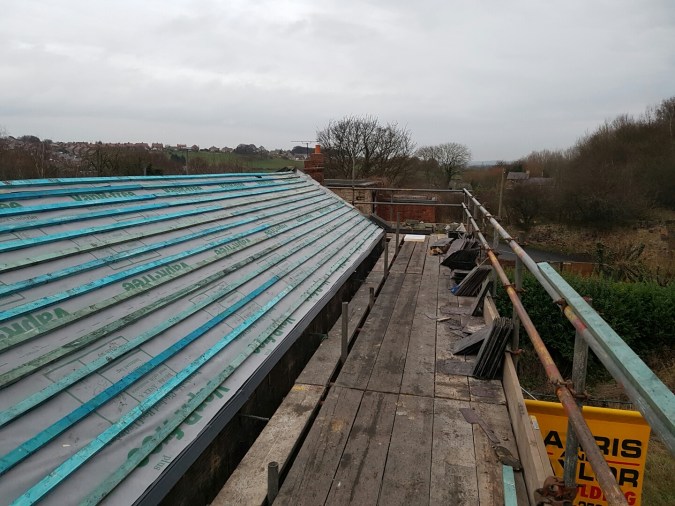

Onto the prepared new battens, the reclaimed and reused blue slates were steadily laid and nailed in place. Meanwhile on the underside of the new roof, thermal insulation was added, improving the heat efficiency of the building. hopefully making the spaces better for visitors and volunteers, and certainly making them somewhat darker, now there were less holes!

21st January 2017

21st January 2017

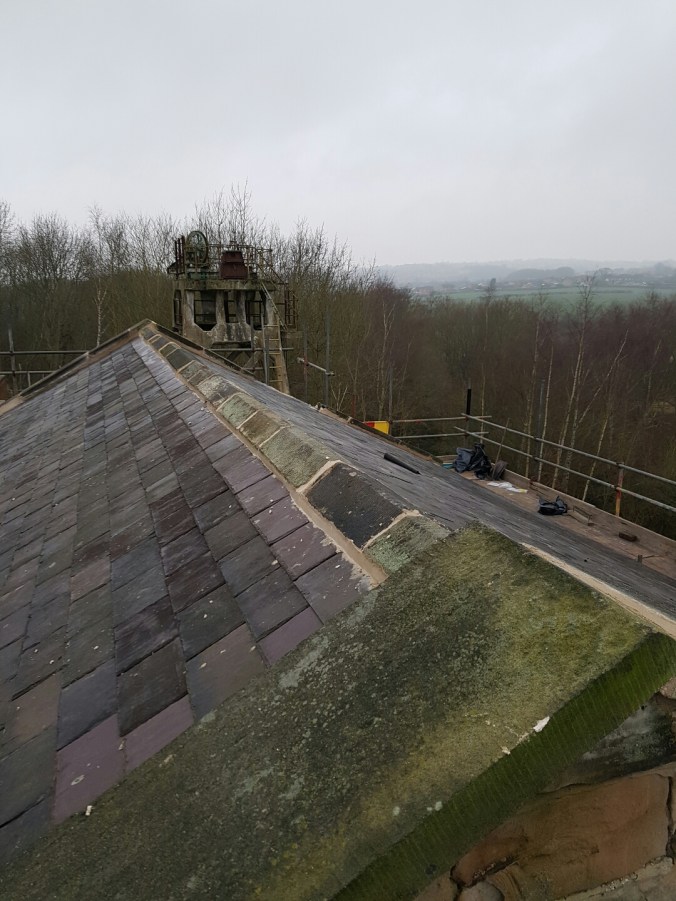

By mid January 2017 excellent progress had been made; the bulk of the re-roofing had taken place, but work remained on the flashing, guttering and drainage profile of the roof. After substantial timber replacement  in the wall board and rafters, the trickiest element of the roof to repair was the last pitch, between the narrow enginehouse and the later brick extension.

21st January 2017

21st January 2017

Guttering

Aluminium guttering and down pipes, made to heritage standards, to appear like cast iron were added in and many points in the walls supporting the roof timbers were repointed and consolidated to strengthen the building as a whole.

Guttering detail: profile of aluminium metalwork. (21st January 2017)

Finishing off

In January into February the ridge stone work was put back into place on the buildings, the builders carefully leaving small apertures to allow for egress of any potential bat species in future. In January much work was done to the winding engine house window, including the insertion of a generous owl habitat box into the roofspace of the building.

New owlspace

New owlspace

Alongside the temporary owl box attached to the concrete headgear, this step marked an important sign of the delivery of the ecological goals of the restoration – supporting wildlife in the area whilst ensuring the future of the building.

18th February 2017

In the week before the Open Day on 18th February 2017, the scaffolders returned to site, this time to remove the poles and boards and reveal the finished fruits of the roofers’ work.

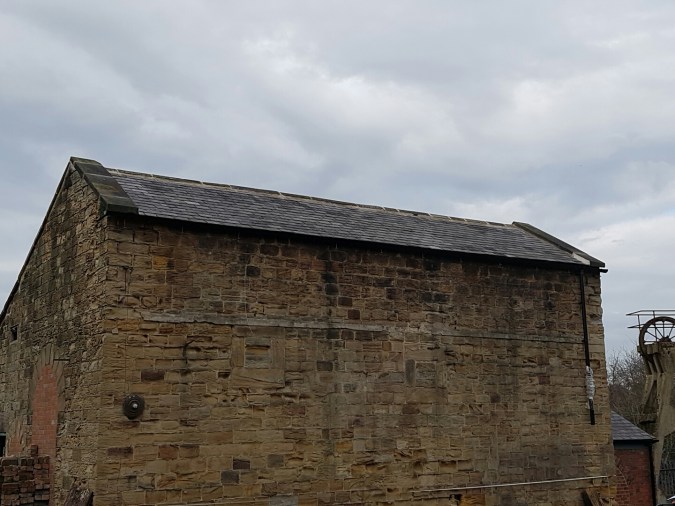

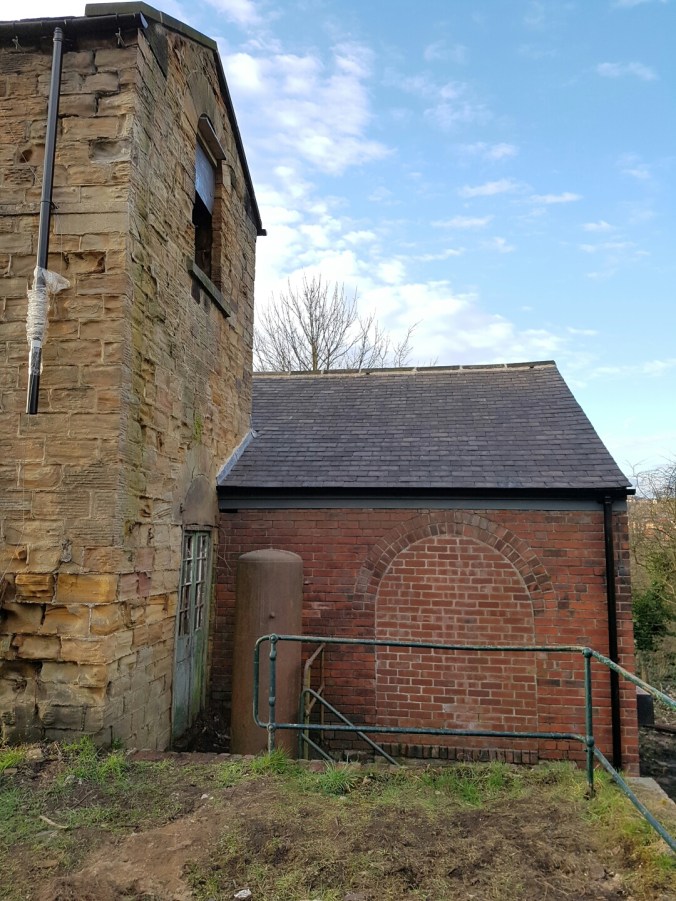

18th February 2017, completed roofwork, scaffolding removed

18th February 2017; scaffolding removed.

18th February 2017; scaffolding gone.
